Encinitas Mobility Projects Tracker
In March 2025, the City of Encinitas published the Engineering Capital Projects By Status Fy 2025-2026. This spreadsheet shows all of the projects for the city, including mobility, parks & recreation, drainage, coastal and public safety, that are in the pipeline for the upcoming fiscal year.
We’ve created a mobility-specific projects tracker that highlights the following:
- Project Name
- Funding Type
- Study & Initial Evaluation Status
- Design Status
- Construction Status
- Project Notes and Funding Needs
- Link to the City Project Page (Some projects don’t have a city project page)
Click the plus (+) before the project name to expand each project and the minus (-) to close it.
Santa Fe Drive (Western Phase)
Grant/Other Funding:
Grant
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Funded/Not Complete
Notes/Unfunded Estimate:
Construct w/Santa Fe East

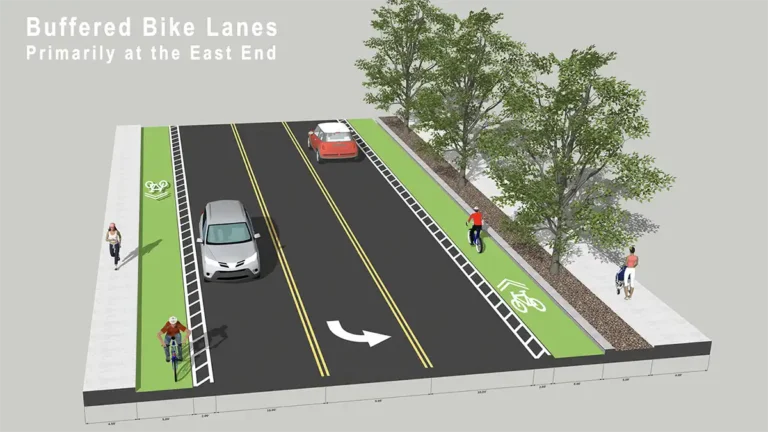

Santa Fe Drive (Eastern Phase)
Grant/Other Funding:
Grant
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Funded/Not Complete
Notes/Unfunded Estimate:
Start construction in FY 25/26
Citywide Leading Pedestrian Intervals (LPI) Project
Grant/Other Funding:
Grant
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Funded/Not Complete
Notes/Unfunded Estimate:
In Construction, Complete in 25/26
Citywide Pedestrian Crossing Upgrades
Grant/Other Funding:
Grant
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Funded/Not Complete
Notes/Unfunded Estimate:
Start construction in FY 24/25

Protected Intersection at S El Camino Real & Santa Fe Dr
Grant/Other Funding:
Grant
Study/Initial Evaluation:
Complete
Design:
Funded/Not Complete
Construction:
Funded/Not Complete
Notes/Unfunded Estimate:
Start construction in FY 25/26
S Coast Highway 101 Pedestrian Crossing at Solana Beach
Grant/Other Funding:
Grant
Study/Initial Evaluation:
Complete
Design:
Funded/Not Complete
Construction:
Partially Funded
Notes/Unfunded Estimate:
$38,800, if approved

S Coast Highway 101 East Side Sidewalk
Grant/Other Funding:
Grant
Study/Initial Evaluation:
N/A
Design:
Funded/Not Complete
Construction:
Partially Funded
Notes/Unfunded Estimate:
$186,920, if approved

Encinitas Boulevard Protected Bike Lane
Grant/Other Funding:
Grant
Study/Initial Evaluation:
N/A
Design:
Funded/Not Complete
Construction:
Partially Funded
Notes/Unfunded Estimate:
$89,040, if approved

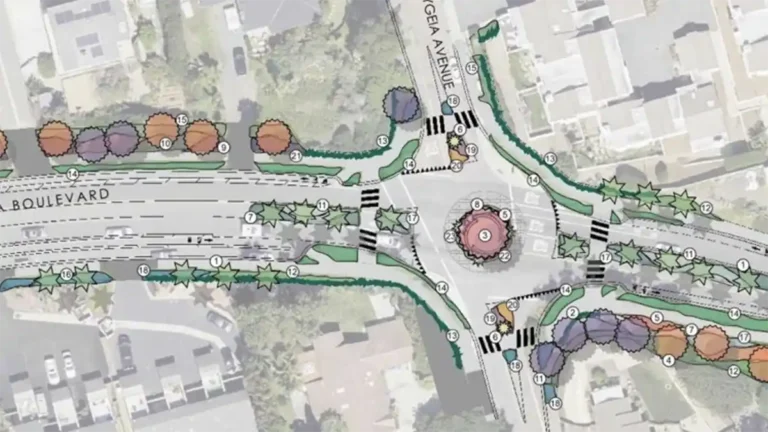

Leucadia Blvd Roundabout at Hygeia (Roundabout Only)
Grant/Other Funding:
Grant
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Unfunded
Notes/Unfunded Estimate:
$3,900,000
Leucadia Blvd Roundabout at Hygeia (Pedestrian Improvements Only)
Grant/Other Funding:
Other
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Unfunded
Notes/Unfunded Estimate:
$820,000

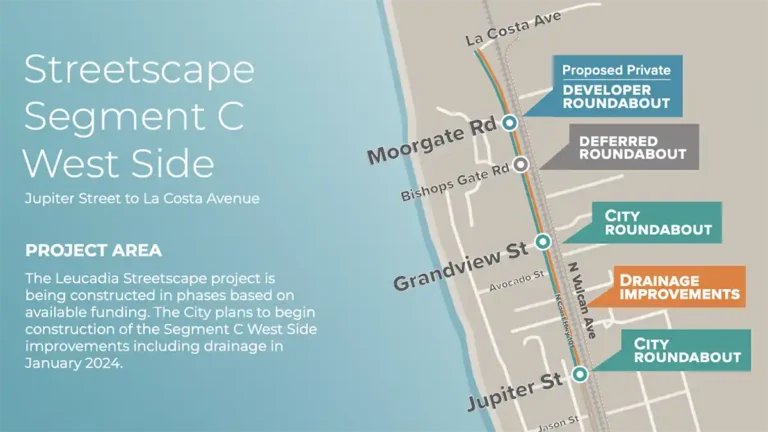

Leucadia Streetscape Segment C West (Jupiter St - La Costa Ave)
Grant/Other Funding:
Other
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Funded/Not Complete
Notes/Unfunded Estimate:
In Construction, Complete in 26/27

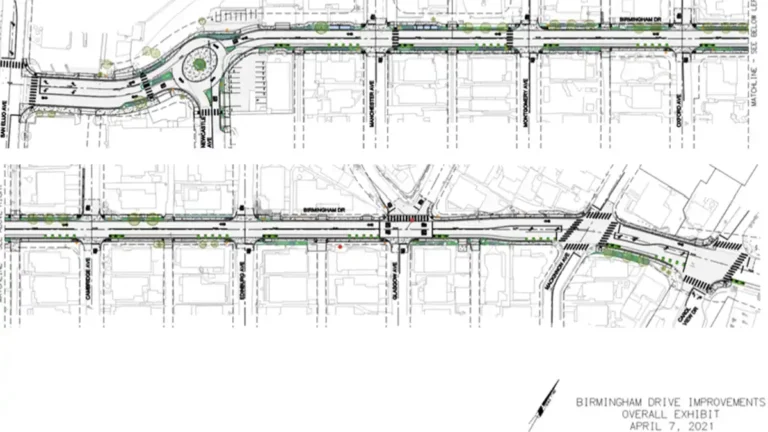

Birmingham Drive Complete Streets
Grant/Other Funding:
No
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Unfunded
Notes/Unfunded Estimate:
$30,100,000

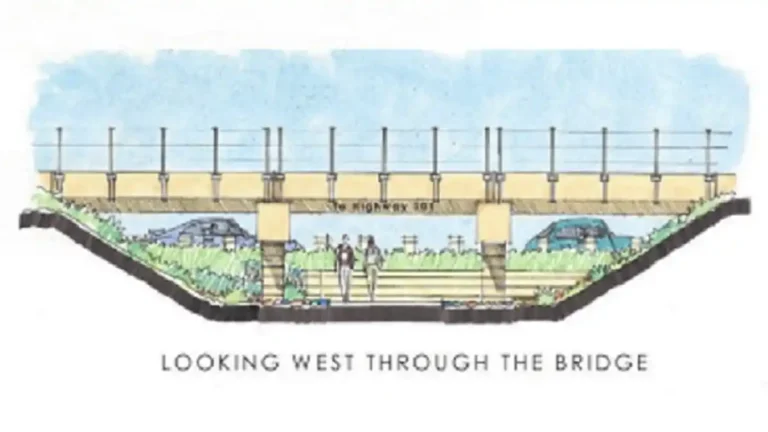

Verdi Pedestrian Undercrossing
Grant/Other Funding:
No
Study/Initial Evaluation:
Complete
Design:
Complete
Construction:
Unfunded
Notes/Unfunded Estimate:
$17,850,000
Leucadia At-Grade Rail Crossings
Grant/Other Funding:
No
Study/Initial Evaluation:
Complete
Design:
Funded / Not Complete
Construction:
Unfunded
Notes/Unfunded Estimate:
$6,150,000

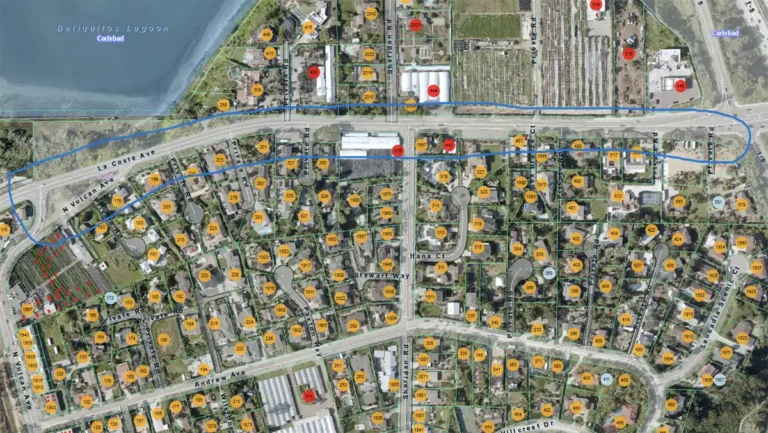

La Costa Avenue Pedestrian Path
Grant/Other Funding:
No
Study/Initial Evaluation:
N/A
Design:
Funded / Not Complete
Construction:
Unfunded
Notes/Unfunded Estimate:
$1,230,000
Vulcan Pedestrian Path (Leucadia Blvd to La Costa Ave)
Grant/Other Funding:
No
Study/Initial Evaluation:
Complete
Design:
Unfunded
Construction:
Unfunded
Notes/Unfunded Estimate:
TBD
